Master Production Scheduling
MPS
Actionable plan
Specifics
What
How many
Finished goods will be produced
Good used of resources, making delivery promises, tradeoffs and strategic objectives
Anticipated schedule of demand
Bill of Materials
BOM
Usually part numbers
Product specifications
Input
Beginning inventory
Sales forecast for end item
: labour
Output
Production per period needs to meet customer demand
Trade off between costs and product availability
Aggregate Plan
Overall
: January, produce 100 tractors of all models
Disaggregate Plam
More specific
Total 8 weeks, 4 weeks per month
2 models
Demand for A: 40%, B: 60%

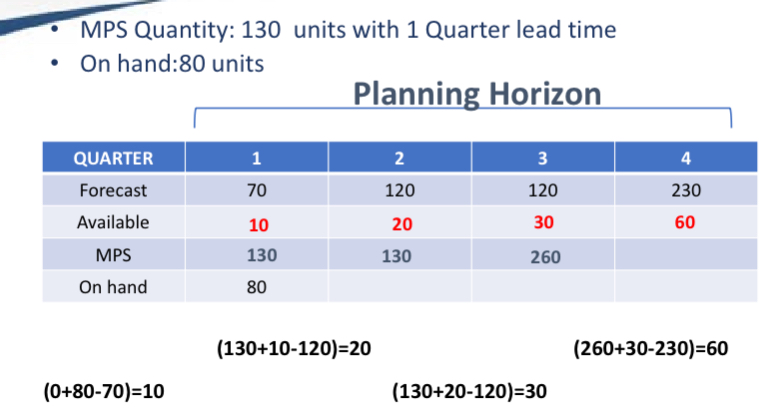

Time-Phased MPS Record
Record item
Forecast demand
Lead time

MPS Record Initial Factors
On hand delivery
Safety stock
MPS quantity and

Final Assembly Schedule
FAS
States the send of end products to be built over a time period
Used with 2 level MPS coordinate component production
No new orders

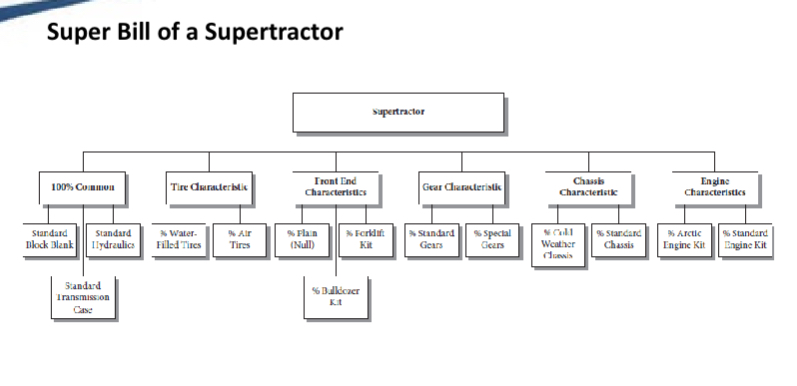

Superbill
Large combinatorial number of end items
Focus on options than end items
Rep MPS units in smaller number of super units
Super end item
Reduce end items but very sophisticated

Covering Sets
Uses end items in MPS, doesn’t include all
MRP logic
Quantity adjusted to cover all expected subassemblies and components

Master Scheduler
Provide deliver promising dates for incoming orders
Eval impact of:
Top down inputs
Bottom up input
Revise master schedule
