1
New cards

Risk

Risk = probability * impact

2
New cards

The black swan case

The probability is almost 0 that the event will happen

But the impact is really huge.

And the history is define by those black swans

3
New cards

Schedule risk analysis steps

  1. Define point of reference (baseline schedule)

  2. Identify the risk (uncertainty) - add distributions of the duration of each activity

  3. Analyse the risk with Monte Carlo Simulation (risk analysis technique where the computer runs thousands of project scenarios based on uncertainty inputs (best case / most likely / worst case) for each task, and the output provides the probability of completing the project by a certain date)

  4. Interpretation of the output

4
New cards

Output interpretation indexes

  • CI - criticality index

The probability that an activity lies on the critical path (slack = 0)

CI = P (SL = 0) - probability that slack = 0

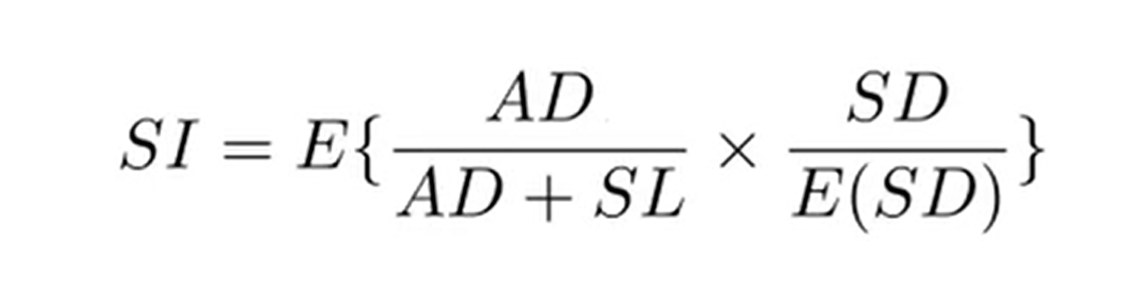

  • SI - significance index - measures the impact of variability in activity durations on the total project duration.

AD - activity duration

SL - slack

SD - simulated duration

E{x} - expected value of x (average value of all simulations)

  • SSI - schedule sensitivity index - multiplies the standard deviations of the activity durations and project duration (approximately impact) with the criticality index (probability)

<ul><li><p><strong>CI - criticality index</strong></p></li></ul><p>The <strong>probability </strong>that an activity lies on the critical path (slack = 0)</p><p><em>CI = P (SL = 0)</em> - probability that slack = 0</p><ul><li><p><strong>SI - significance index</strong> - measures the <strong>impact</strong> of variability in activity durations on the total project duration.</p></li></ul><p>AD - activity duration</p><p>SL - slack</p><p>SD - simulated duration</p><p>E{x} - expected value of x (average value of all simulations)</p><ul><li><p><strong>SSI </strong>- schedule sensitivity index - multiplies the standard deviations of the activity durations and project duration (approximately <strong>impact</strong>) with the criticality index (<strong>probability</strong>)</p></li></ul><p></p>
5
New cards

SSI is almost equal to CI*SI

More or less, as criticality index = probability, si = impact, but in some extreme cases the product of those two will be different from the actual ssi.

6
New cards

Step 2. Define uncertainty

Uncertainty:

  • In activity duration

  • Probabilistic branch = the relationship btw activities is not always correct (in parallel instead of sequential)

  • Probability activity existence - activity might not exist

Methods:

Statistical estimates (hard to calculate distributions that will correspond to reality)

Three-point estimates - similar to PERT

Risk classes (pragmatic) - often used in reality - group into variation (small variation), foreseen uncertainty (known unknowns), unforeseen uncertainty (unknown unknowns)

7
New cards

On what to focus which metrics to use

For the risk analysis, use SSI more than CI or SI - control efficiency. Under the condition that you use it as an excellent manager (not a control freak or lazy one)

The problem with CI/SI only: you see problems too late

8
New cards

How to capture the money risk

CRU - cruciality index - correlation between the activity cost and total project cost.

Also measures correlation of time

9
New cards

Schedule risk analysis efficiency for serial and parallel networks

Schedule risk analysis works better for parallel networks.

Serial networks - > more likely that activities will lie on a critical path (CI increases), as activities become critical slack decreases (SI increases) → SSI increases. All of them will increase up to 100%, showing all activities as risky ones, hard to focus.

10
New cards

Prioritize risk proposals

Look at the probabilities and impact,so use SSI for that. Highest value - top priority, as it shows the most dangerous activities

Also look at CRU - cruciality index. In case of the most expensive activity, the proposal could be accepted, even if SSI is not very high, but CRU should be found (by rerunning Monte Carlo simulations)
