1
New cards

Put Tuckman's stages of team development in order based on the degree of team development, from least to most.

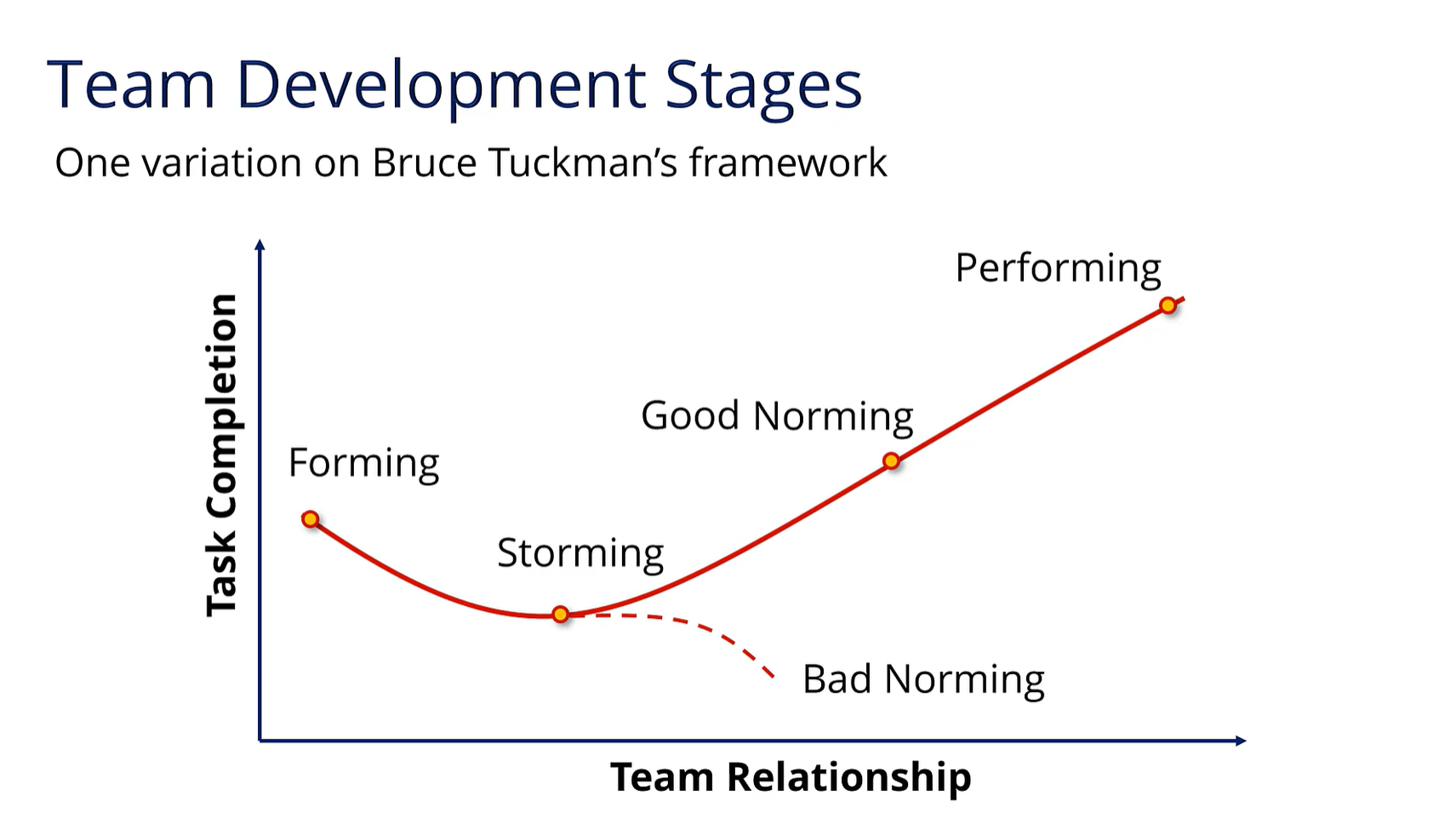

Forming, Storming, Norming, Performing

<p>Forming, Storming, Norming, Performing</p>
2
New cards

How are "good norming" and "bad norming" similar?

Both involve patterns of team behaviour becoming established and accepted or tolerated by the team

3
New cards

What are the five conflict management strategies (name them) and what are the x and y axes of the graph they’re on?

  1. Avoiding, Accommodating, Compromising, Competing and Collaborating

  2. x: Cooperativeness (achieving others’ needs). y: Assertiveness (achieving your needs)


<ol><li><p>Avoiding, Accommodating, Compromising, Competing and Collaborating</p></li><li><p>x: Cooperativeness (achieving others’ needs). y: Assertiveness (achieving your needs)</p></li></ol><p></p>
4
New cards

When do we use avoidance (conflict management)?

It’s helpful if stepping away will help de-escalate tensions and think things through

5
New cards

When do we use accommodation (conflict management)?

Good when the issue is not important to you but you will earn goodwill

6
New cards

When do we use competing (conflict management)?

Consider if the issue is critical to you and action must be taken immediately

7
New cards

When do we use compromising (conflict management)?

Use if time is short and you want to balance team relationships and resolving the issue

8
New cards

When do we use collaboration (conflict management)?

When you have the time to work towards finding the ideal solution for everyone

9
New cards

What are the five traits of effective teams from the Google study?

  1. Dependability: members get work done

  2. Structure and Clarity: team has clear goals

  3. Meaning: work is personally fulfilling

  4. Impact: the work being done matters

  5. Psychological safety: members feel safe taking risks and being vulnerable


10
New cards

What does equity mean?

All team members have an equal opportunity to give their input and contribute to the team’s success

11
New cards

What does diversity mean?

A strength when teams value the uniqueness of team members’ lived experiences, perspectives, and ways of thinking

12
New cards

What does inclusion mean?

Ensuring all members feel comfortable, valued, and included

13
New cards

What effective team trait is EDI directly related to?

Psychological Safety

14
New cards

What is microagression?

It is a brief statement and action that might seem small but communicates (intentionally or unintentionally) hostile, derogatory or negative slights to a specific group. It reduces inclusion.

15
New cards

What is allyship?

Taking action to support those who might otherwise feel excluded

16
New cards

What is the difference between proactive and reactive allyship?

Proactive allyship is where you engage in actions on an ongoing basis to help make marginalized individuals feel included, while reactive allyship is where you support someone after seeing an incident of bias

17
New cards

What does stakeholder salience mean?

How prominent or important a stakeholder is

18
New cards

What is the difference between a stakeholder and a rights holder?

A rights holder had additional human or legal rights

19
New cards
<p><span>A stakeholder with the ability to influence a project</span></p>

A stakeholder with the ability to influence a project

Power

20
New cards
<p><span>A stakeholder with power and urgency but not legitimacy</span></p>

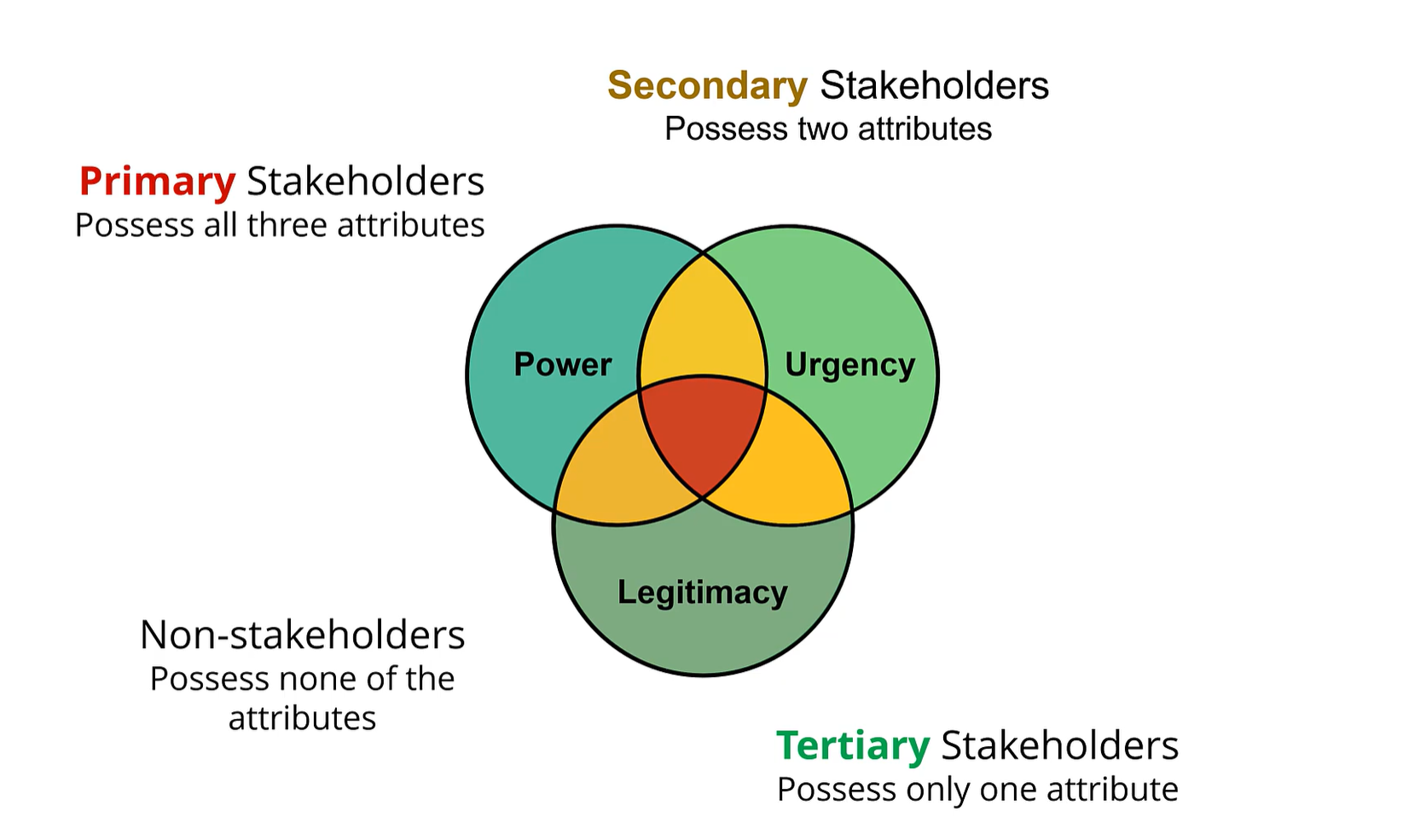

A stakeholder with power and urgency but not legitimacy

Secondary stakeholder

21
New cards
<p><span>A stakeholder who cares deeply about a project even though they are not personally impacted and they have no influence on the project</span></p>

A stakeholder who cares deeply about a project even though they are not personally impacted and they have no influence on the project

Urgency

22
New cards
<p><span>A stakeholder with the ability to stop a project</span></p>

A stakeholder with the ability to stop a project

Power

23
New cards

Which stakeholder group (primary, secondary, tertiary) should engage in presentations, website, open houses?

Primary, secondary and tertiary

24
New cards

Which stakeholder group (primary, secondary, tertiary) should engage in meetings, decision-making boards, and workshops?

Primary

25
New cards

Which stakeholder group (primary, secondary, tertiary) should engage in public meetings, consultation sessions, and in-depth focus groups?

Primary and secondary

26
New cards

Which stakeholder group (primary, secondary, tertiary) should engage in ongoing collaboration?

Primary

<p>Primary</p>
27
New cards

What’s the definition of a stakeholder?

Any person or group who CAN influence a project or IS influenced by a project

28
New cards

What are the three aspects (and their definitions) of the stakeholder salience model?

Power = is able to influence

Urgency has time-sensitive needs

Legitimacy = has a right to have a say

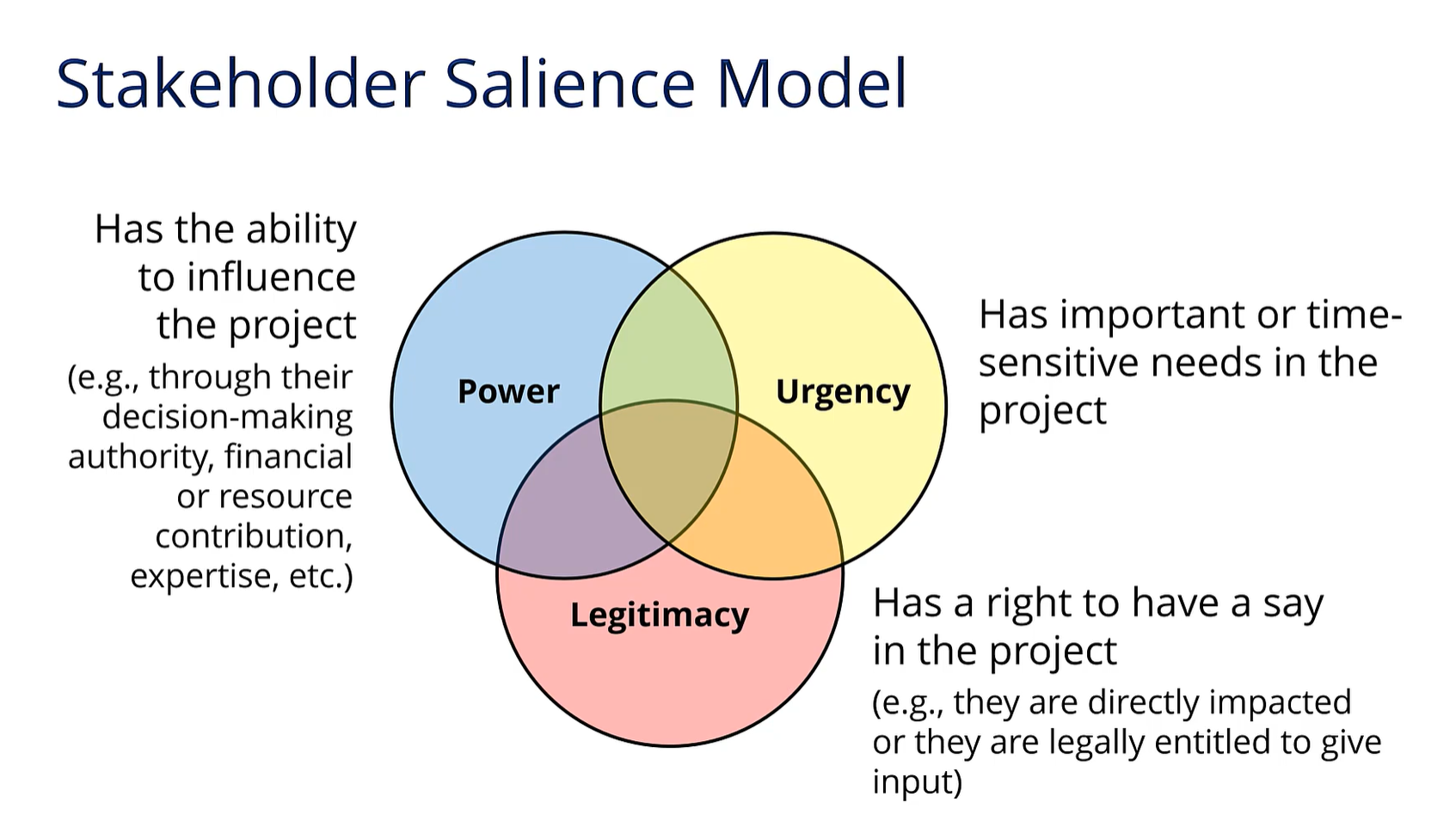

<p>Power = is able to influence</p><p>Urgency has time-sensitive needs</p><p>Legitimacy = has a right to have a say</p>
29
New cards

PERT (including what the formula is)

Project Evaluation and Review Technique

  • Improves estimates of time duration

  • Expected Time = 1/6(optimistic + 4*likely + pessimistic)

  • Used in planning stage to determine task durations


30
New cards

CPM

Critical Path Method

  • Used to determine critical path and slack

  • Needs knowledge of task durations and dependencies

  • You want to use it to help you shorten the timeline as much as possible (reduces project cost)

  • Used in planning stage to determine dependencies and the critical path


31
New cards

Gantt

Used to chronically arrange and visually represent tasks and milestones, assign resources and track project progress and manage adjustments to the plan when needed

  • Used in the plan and manage stage to determine the schedule


32
New cards

What is a project?

A temporary undertaking planned to achieve a particular outcome

33
New cards

What is a project scope?

The breadth of deliverables to be produced and the resources and activities involved in achieving those deliverables

34
New cards

What determines actual project scope?

The extent to which needs are able to be addressed,, typically as restricted by the availability of resources and other constraints

  • More time, more money, more people are needed if the scope is not able to be met


35
New cards

What is scope creep?

Growth in scope for which additional (unplanned and therefore unaccounted for) resources and or activities are needed

36
New cards

What is the iron triangle concept?

knowt flashcard image
37
New cards

What is the project scope statement and what does it include?

Scope statement = a clear description of what is and isn’t part of a project

  • Overall description of the project often including a justification of the project

  • A summary of the project deliverables and their key features

  • The acceptance criteria to successfully complete the project

  • A list of constraints to the projects (e.g. time limits, cost, etc.)

  • A description of any major assumptions made in determining scope

  • An explicit list of what will be excluded from the project (outside of scope)


38
New cards

What is a Work Breakdown Schedule (WBD)?

  • Divides the project into manageable pieces (by individual project products (/deliverables) or projects phases/products)

  • Used to lay out all the products BEFORE figuring out what work is needed to figure out the tasks, estimating task duration and finding the critical path and making a Gantt chart

  • Focus on all deliverables (products) not tasks

  • Hierarchical structure, divided into levels


<ul><li><p>Divides the project into manageable pieces (by individual project products (/deliverables) or projects phases/products)</p></li><li><p>Used to lay out all the products BEFORE figuring out what work is needed to figure out the tasks, estimating task duration and finding the critical path and making a Gantt chart</p></li><li><p>Focus on all deliverables (products) not tasks</p></li><li><p>Hierarchical structure, divided into levels</p></li></ul><p></p>
39
New cards

What are examples of deliverables found in a WBS?

  • Physical deliverables (prototype)

  • Other deliverables (EOI, presentations)

  • Internal products (team operating principles document, Gantt charts)

  • Other products (budget for the pilot)


40
New cards

What is a work package?

The smallest divisible unit of a project (can be found in WBS)

41
New cards

Guidelines for making a WBS (4)

  • Include only products (i.e. deliverables) not tasks

    • Products: “Target design specifications”, “EOI”

    • Tasks: “Conduct stakeholder interviews”, “research”

  • Include all products of a project

    • WBS represents 100% of the work effort on the project

  • The same product does not appear in more than one place

    • Even if work for a certain deliverable can happen during multiple stages, it should only appear once on the WBS

  • Divide by product not task

    • The task of “prepare recommendations” can be part of many products (e.g. “EOI”, “presentation”, etc.)


<ul><li><p>Include only products (i.e. deliverables) not tasks </p><ul><li><p>Products: “Target design specifications”, “EOI”</p></li><li><p>Tasks: “Conduct stakeholder interviews”, “research”</p></li></ul></li><li><p>Include all products of a project</p><ul><li><p>WBS represents 100% of the work effort on the project</p></li></ul></li><li><p>The same product does not appear in more than one place</p><ul><li><p>Even if work for a certain deliverable can happen during multiple stages, it should only appear once on the WBS</p></li></ul></li><li><p>Divide by product not task </p><ul><li><p>The task of “prepare recommendations” can be part of  many products (e.g. “EOI”, “presentation”, etc.)</p></li></ul></li></ul><p></p>
42
New cards

The WBS represents _________ of the work effort on a project

100%

43
New cards

After a scope statement and WBS, what is missing during planning?

  • Need to figure out what tasks are required to deliver each work product in the WBS and the order the tasks are performed

  • Need to figure out what resources are needed when


44
New cards

What are the steps to perform scheduling? (3)

  1. Begin by listing all the teasks for each deliverable in the WBS

  2. Use PERT to help initially define each task duration

  3. Once durations are determined, then focus on task dependencies (there might be more than one type of dependency)


45
New cards

Can you keep identifying requirements as you start tasks?

Yes

46
New cards

Task Dependencies during Scheduling (4 types)

  1. Finish to Start = finish Task A to start Task B

  2. Finish to Finish = finish Task A to finish Task B

  3. Start to Start = start Task A to start Task B

  4. Start to Finish = start Task A to finish Task B


<ol><li><p>Finish to Start = finish Task A to start Task B</p></li><li><p>Finish to Finish = finish Task A to finish Task B</p></li><li><p>Start to Start = start Task A to start Task B</p></li><li><p>Start to Finish = start Task A to finish Task B</p></li></ol><p></p>
47
New cards

What does CPM need as inputs to show the critical path (2 things)?

  1. Task durations

  2. Dependencies


48
New cards

How to initially allocation resources (part of scheduling)? (5 points)

  1. Perform an initial assignment of resources for tasks starting with the critical path

  2. Work to optimize resources

  3. Check the critical path

  4. Rework as required to balance resources with scope

  5. Consider Effort-Driven Scheduling which can shrink task durations by applying more effort (resources) to get a task completed more quickly


49
New cards

What kind of diagram is best for assignment of resources (part of scheduling)?

Gantt because it better shows the timeline and workload (e.g. compared to the WBS)

50
New cards

What does work (aka effort) mean (part of scheduling)?

The person-hours estimated needed for a task

51
New cards

Effort-Driven Scheduling

Shrink task durations by adding more effort (resources) to a task

52
New cards

What does duration mean (part of scheduling)?

The time period in which the task starts and finishes

53
New cards

What does actual work mean (part of scheduling)?

The actual amount of work performed to complete a task

54
New cards

What to consider to track and show progress on a Gantt Chart (3)?

  1. Establish a baseline (snapshot of initial Gantt chart) so what updates have a basis for comparison

  2. Show a “work” column to indicate how many person hours are estimated for each task

  3. Showing an “actual work” column for reporting how many person hours have been applied to a task


55
New cards

What is the critical path?

The minimum time to project completion. We cannot delay any task on the critical path without delaying the entire project.

56
New cards

What is slack?

The amount of time we can delay a task without delaying the project completion time

57
New cards
<p>What is the critical path in this diagram?</p>

What is the critical path in this diagram?

EFG

58
New cards
<p>What is the project duration if the team only has one person?</p>

What is the project duration if the team only has one person?

One person means two tasks can’t happen at the same time. 15 days.

59
New cards
<p>What is the minimum possible project duration if there is always one person per task?</p>

What is the minimum possible project duration if there is always one person per task?

This is the same as the critical path. 7 days.

60
New cards
<p>What is the slack for C? D? G?</p>

What is the slack for C? D? G?

The critical path project time is 7 days. So normally C is done in 6 days so it can wait 1 day. For D it can wait 3 days and if G continues as planned then it will be 5 + 2 = 7. For G, EF already takes 5 days so it has no days of slack.

  1. For C: 1 day

  2. For D 3 days

  3. For G: 0 days


61
New cards
<p>What is the maximum time between earliest project finish and start of C?</p>

What is the maximum time between earliest project finish and start of C?

The earliest task C can start is after A and B are done (A = 2 and B = 1 so 3 days total. That means C starts at day 3 and the whole project finishes at day 7. So the max time between those is 4 days.

62
New cards

For Gantt charts, how do tasks appear?

They are shown as bars and written in action object form. E.g. “Identify stakeholders” is a task, and “identify” is the action while “stakeholders” is the object.

63
New cards

For Gantt charts, how do milestones appear?

Milestones are significant project accomplishments and shown as diamonds, written in object action form. (e.g. “Needs report complete”, object is “needs report” and “complete” is the action)

64
New cards

Put the project management phases in order. (4)

  1. Define

  2. Plan

  3. Manage

  4. Close


65
New cards
<p>What is the critical path?</p>

What is the critical path?

ABG

66
New cards
<p><span>How much slack does task G have on this CPM chart?</span></p>

How much slack does task G have on this CPM chart?

1 unit

67
New cards
<p><span>By how long could task E be delayed without affecting the project completion date?</span></p>

By how long could task E be delayed without affecting the project completion date?

2 units

68
New cards

What commonly appears directly on a Gantt chart? (4)

  • Task start dates

  • People assigned to a task

  • Task durations

  • Degree of task completion


69
New cards

What would the PERT method suggest the expected task duration should be if a team believes they should be able to finish the task in 5 days, but it could take 14 days if things do not go well, or it could take 2 days if everything goes perfectly?

6 days

70
New cards

What is a needs statement? (4)

  • Attribute of the product-to-be

  • Interpreted by the design team from stakeholder interviews and other information gathering

  • Primarily qualitative

  • Solution independent (describes WHAT should be achieved, not how)


71
New cards

What are the two main guidelines for writing a needs statement?

  1. Write in positive form (don’t write what the product shouldn’t do)

  2. Don’t use “must” and “should”


72
New cards

What are the main types of needs? (3)

  1. Expressed = stated by stakeholders

  2. Threshold = expected but not stated by stakeholders

  3. Latent = unexpected and unstated (but it can make them happy if you meet the need)


73
New cards

What are the categories of needs? (6)

  1. Functional = related to what the design is intended to do

  2. Undesirable = unwanted by-products of trying to achieve other goals (e.g. costs)

  3. Regulatory = codes and standards the device must conform to

  4. Safety = specific hazards that needs to be addressed

  5. Input/output constraints = e.g. how much power is needed, etc.

  6. Durability = reliability expectations (e.g. maintenance intervals, etc.)


74
New cards

An appropriate requirement is…?

  • Necessary = in no cases can be violate a requirement and still have an acceptable solution

  • Unambiguous = only one interpretation for the requirement

  • Verifiable = it must be possible to determine whether or not its satisfied

  • Achievable = describes what must be achieved (not how) and not contradict other requirements


75
New cards

What do target design specifications do?

  • Requirements and evaluation criteria

  • Precise and quantitative


<ul><li><p>Requirements and evaluation criteria</p></li></ul><ul><li><p>Precise and quantitative</p></li></ul><p></p>
76
New cards

Do all evaluation criteria correspond to a requirement?

No.

77
New cards

How do we quantify evaluation criteria?

Using a graph

<p>Using a graph</p>
78
New cards

What is validation?

Confirm with stakeholders that needs are complete and correct, and that they have been properly translated into target design specifications

79
New cards

Can needs statements come from research on something other than the stakeholders?

Yes

80
New cards

Explain what the issue is with these needs statements (NOT all have an issue)

  • Device uses rechargeable batteries for power

  • Device must operate without diesel fuel

  • Device does not emit toxic fumes

  • Device operates in all weather conditions found in Metro Vancouver


  • The first statement violates because needs statements are not supposed to prescribe a certain solution

  • Second statement uses “must”

  • Third statement is negative “does not”

  • This one is fine


81
New cards

What needs category is “Time to recharge system is less than 60 minutes” found in and why?

Undesirable because it’s something we want to minimize, not really related to the function of the actual device

82
New cards

Select all valid and suitable requirements below assuming the following: the design is for a battery-powered, handheld device; the design is being completed in time for production and distribution by end of year; and a second requirement, "Device uses only commercially-available AA batteries for power," exists and has been adopted.

  • The device accommodates batteries of standard length between 49.2 and 50.5 mm

  • The device shall function with both Duracell and Energizer brand AA batteries

  • Batteries can be replaced in about 30 to 60 seconds

  • A photovoltaic cell ("solar panel") may be used to supplement battery power

  • The device has an indicator to show when there is sufficient battery charge to operate the device

  • The device operates continuously for at least 200 hours before batteries need to be replaced

  • A door to the battery compartment retains batteries under normal use


  • NO: Might conflict with other requirement “device uses only commercially-available AA batteries”

  • NO: Might conflict with other requirement “device uses only commercially-available AA batteries” and prescribes a specific solution

  • NO: “about” is vague

  • NO: “may” is vague

  • YES: Specific, doesn’t conflict

  • YES: Specific, doesn’t conflict

  • NO: “under normal use” is vague


83
New cards

What is risk?

Risk = Severity (of harm, consequences, or damage) x Likelihood (of the incident occurring)

84
New cards

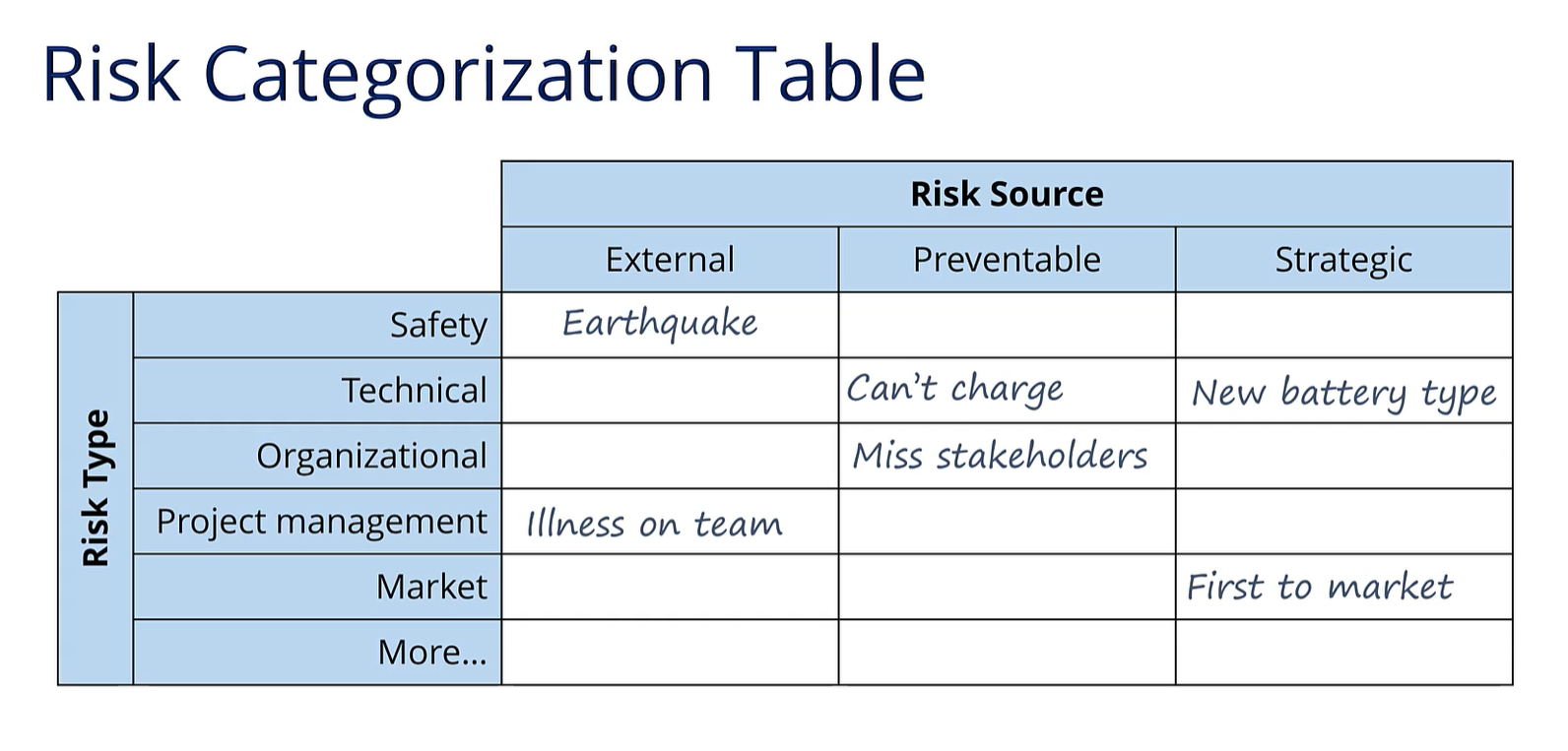

What is the Risk Categorization Table?

Risk Type vs Risk Source table

  • Allows engineers to anticipate and address as many potential risks as possible


<p>Risk Type vs Risk Source table</p><ul><li><p>Allows engineers to anticipate and address as many potential risks as possible</p></li></ul><p></p>
85
New cards

What are the risk types? (5)

  • Safety = relating to the health and welfare of people and the environment

  • Technical = relating to design and manufacture to ensure solution works as intended

  • Organizational = relating to decision making and operational aspects

  • Project management = relating to completing a project on time and on budget

  • Market = relating to correctly understanding stakeholder needs and alternatives available to them


86
New cards

What are the risk sources? (3)

  • External = risks outside an organization’s control but still need to be accounted for

  • Preventable = risks to be minimized and within and engineer/organization’s control

  • Strategic = risks knowingly accepted with the hopes of a greater return/reward


87
New cards

What is the Risk Matrix?

Likelihood vs Severity Table (cells are the products of the two and are sometimes color coded)

  • Used to prioritize risks and identify those that require action to address


<p>Likelihood vs Severity Table (cells are the products of the two and are sometimes color coded)</p><ul><li><p>Used to prioritize risks and identify those that require action to address</p></li></ul><p></p>
88
New cards

What are the four risk management strategies?

  1. Avoid = change what you are doing to remove the risk

  2. Mitigate = minimize the likelihood or severity of the risk

  3. Transfer = pass the risk onto someone else (e.g. insurance)

  4. Accept = be wiling to live with the consequences of an incident (best for minor risks and strategic risks, those that do not involve safety)


89
New cards

What are the three phases in the concept selection process?

Screening, Ranking, Scoring

<p>Screening, Ranking, Scoring</p>
90
New cards

What is screening?

Remove concepts from consideration that can never be made to work

91
New cards

What is ranking?

Roughly sort concepts to identify the subset with the highest likelihood of success

  • Used to manage a large number of ideas, so we can skip this step if not many ideas pass screening


92
New cards

What is scoring?

Analyze concepts in detail to quantitatively determine the one that maximizes overall satisfaction/value

93
New cards

What controls value?

knowt flashcard image
94
New cards

What are design parameters controlled by?

Engineers

<p>Engineers</p>
95
New cards

What are attributes important to?

Stakeholders

<p>Stakeholders</p>
96
New cards

What are some elements we need to consider in screening? (3)

  1. Requirements = all requirements from the target design specifications

  2. Feasibility = whether the idea can actually achieve its purpose (often considered using order of magnitude physics and estimates)

  3. Technical Readiness (does the team have/can find the expertise to design the solution)


97
New cards

What are some tools used for ranking?

  • Pair-Wise comparison (1 for better, 0.5 for tie)

  • Pugh Chart (ideas are compared to a datum)


<ul><li><p>Pair-Wise comparison (1 for better, 0.5 for tie)</p></li><li><p>Pugh Chart (ideas are compared to a datum)</p></li></ul><p></p>
98
New cards

What are the strengths and weaknesses of ranking? (strengths 2, weaknesses 3)

Strengths

  • Quick

  • Can work with incomplete data

Weaknesses

  • Based on qualitative data

  • Subject to biases

  • Results are not robust


99
New cards

What are some tools scoring uses?

  • Weighted Decision Matrix (WDM) = table with how well the ideas score for each evaluation criterion

  • Value equation = a function based on all the scores from each evaluation criterion


<ul><li><p>Weighted Decision Matrix (WDM) = table with how well the ideas score for each evaluation criterion</p></li><li><p>Value equation = a function based on all the scores from each evaluation criterion</p></li></ul><p></p>
100
New cards

What are the strengths and weaknesses of a WDM?

Strengths

  • Well understood

  • Commonly used

  • Documents scoring work

Weaknesses

  • Time consuming

  • May not accurately represent value
